• Home
  • Corridor Overview
    • West Extension
    • East Extension
  • Map
  • Schedule
  • Gallery
  • FAQs
  • Documents
  • Contact
  • Home
  • Blog
  • All Updates, East Extension
  • Project Update 11/20/25

Project Update 11/20/25

November 20, 2025

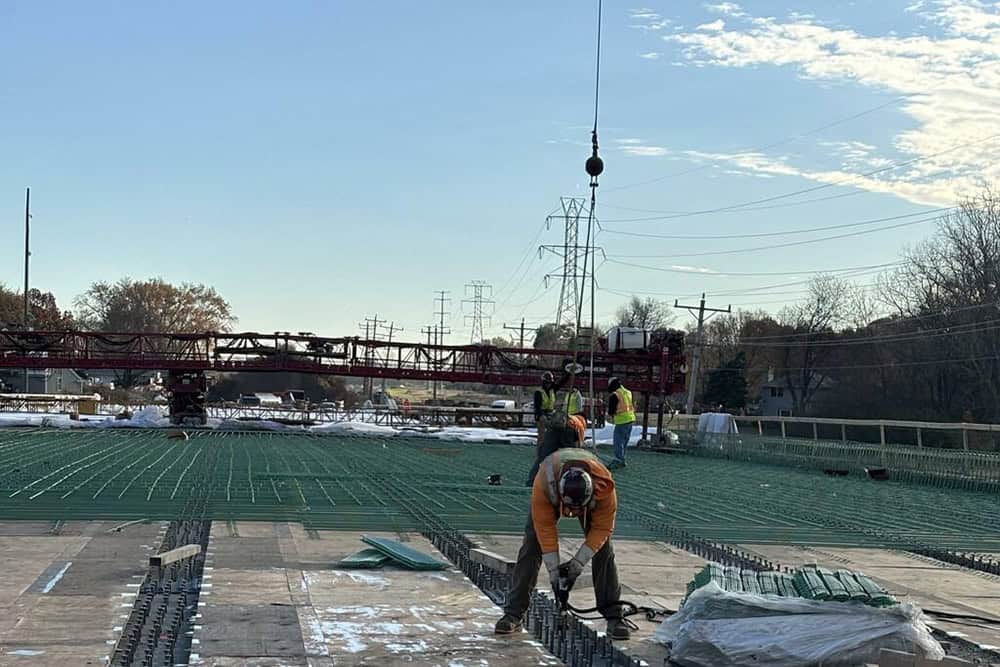

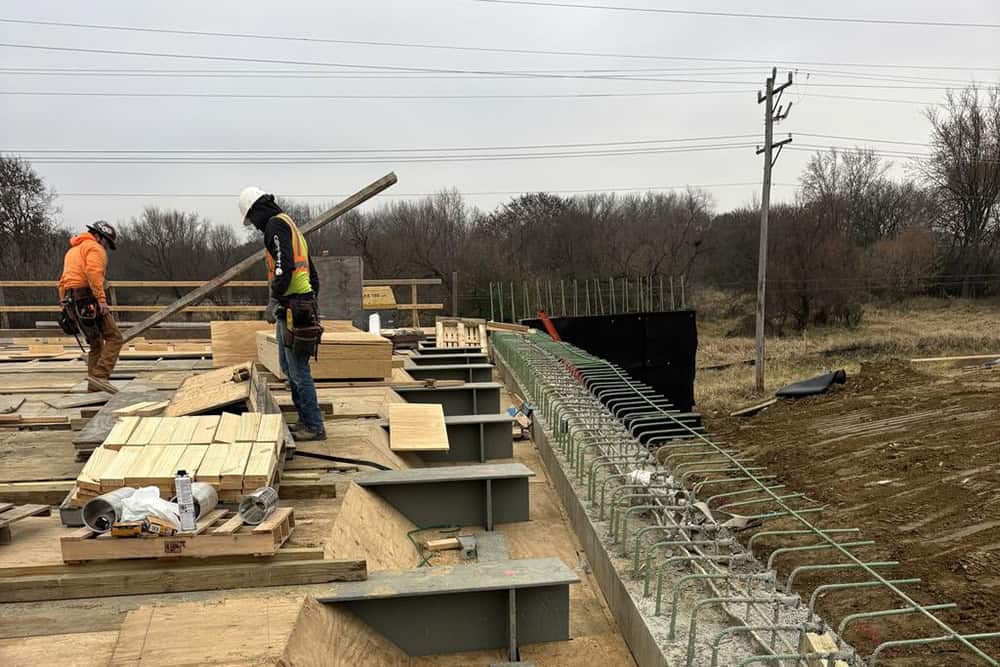

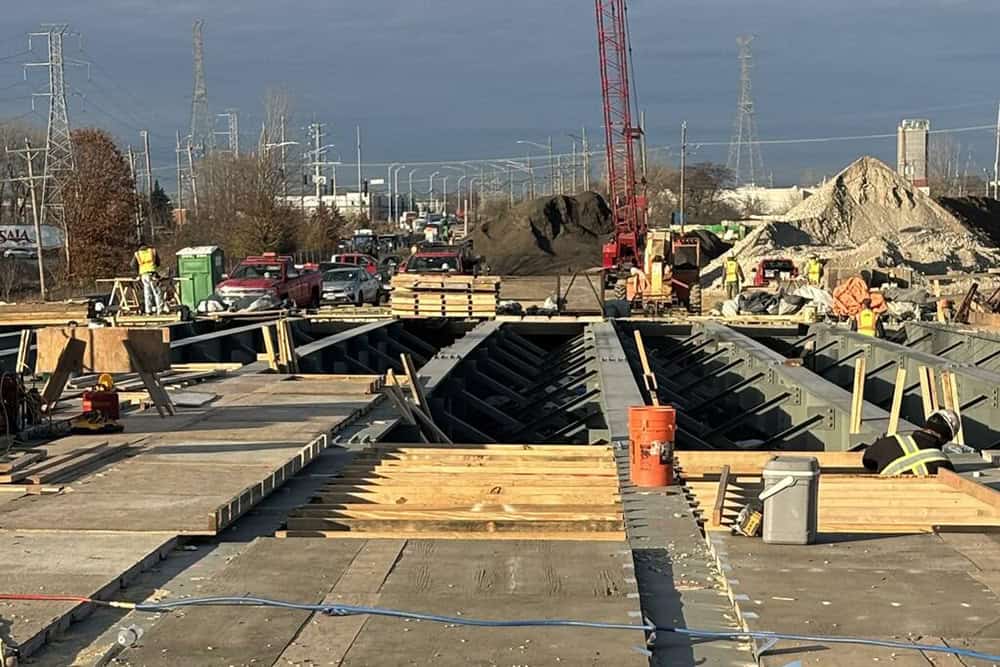

This week the contractor continued forming and installing shear studs and reinforcement for the rest of the bridge deck, backfilled the west abutment, switched Naperville Road traffic to Stage 2 configuration, removed Stage 2 Naperville Road pavement, and continued excavation of the west compensatory storage basin.

Next week the contractor is scheduled to pour the rest of the bridge deck and continue excavation for west compensatory storage basin and Naperville Road Stage 2 roadway.

To view near real time views of construction progress, please check out the Webcam Feed on the Gallery Page.

Thank you for your interest in the 143rd Street East Extension Improvements. Stay tuned to the website for future updates.

Please drive carefully through the construction zone, refrain from cell phone use, and watch for equipment and workers.

  • East Extension
  • Home
  • Village of Plainfield
  • Documents

All rights Reserved
